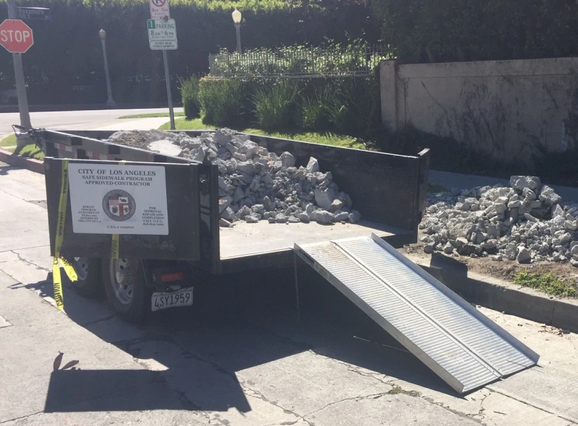

Los Angeles City Controller Ron Galperin today released an audit of the city's sidewalk repair program. In the report, Repairing L.A.’s Broken Sidewalk Repair Strategy, Galperin cites several city practices that get in the way of the program being effective. The city has focused funding primarily on repairing sidewalks next to city-owned properties, at the expense of focusing where repairs are most needed based on pavement condition and pedestrian volumes.

Additionally, when the city fixes a sidewalk, it replaces the sidewalk for the entire parcel, which makes repairs more costly and time consuming than necessary.

At a press conference this morning, the controller spoke alongside City Councilmember Bob Blumenfield and community group representatives: Jessica Meaney of Investing in Place, Lillibeth Navarro of Communities Actively Living Independent and Free, and John Yi of Los Angeles Walks. Watch the full event on Facebook live.

Under the 2016 Willits lawsuit settlement, the city committed to spend $1.37 billion over 30 years to address broken sidewalks, inaccessible curb ramps, and other barriers to pedestrian access. Though the city has made some progress since 2016, Galperin found that "less than one percent of sidewalk parcels have been certified as repaired and there is a backlog of 50,000 sidewalks that need to be fixed."

Per Galperin:

    • Over the last five fiscal years, the city received more than 1,700 claims and 1,020 lawsuits for sidewalk injuries, paying out more than $35 million in settlements, including $12 million in fiscal year 2020.
    • The city has completed Willits settlement-related sidewalk repairs at 2,100 sites — a small fraction of locations that need fixing.
    • There are another 50,000 reported sidewalk problems that haven’t been addressed.
    • As of the end of June 2021, the city had issued certificates of compliance to less than 1 percent of sidewalk parcels in Los Angeles.
    • In fiscal year 2021, it took the city 41 days on average to complete the most basic sidewalk fixes (like patching small cracks) compared to 3 days to fill street potholes.
    • The city doesn’t know how many sidewalk locations actually need repair and how much the repairs will cost. Other big U.S. cities have performed citywide sidewalk assessments, but L.A. has refused to do so.

Galperin's recommendations include:

    • Change city law to allow for the repair of individual sidewalk defects instead of requiring an entire parcel to be fixed.
    • Alter the prioritization system so that sidewalks next to residential and commercial properties can be considered for repair right away.
    • Work to provide quicker short-term responses to sidewalk problems reported by the public.
    • Invest in a citywide condition assessment of all sidewalks and curb ramps to identify locations that need urgent fixes.
    • Pursue additional funding to address the mounting backlog of sidewalk requests.

On that last funding note, several speakers this morning pointed to specific funding that the city could use to repair its sidewalks. Meaney remarked that the city can and should use existing transportation tax monies - like Measure M and R local return - to repair sidewalks. Councilmember Blumenfield asserted that the city could use federal infrastructure money to repair sidewalks.

Find the full sidewalk repair report at the Controller website.

Stay in touch

Sign up for our free newsletter

More from Streetsblog California

Streets for All: SoCal Could Fund All of Southland’s High-Speed Rail with EIFD

Streets for All report shows that all of SoCal High-Speed Rail could be funded with EIFD's, with money leftover to support local transit.

March 25, 2026

Wednesday’s Headlines

More news on legislation and transit funding as Mayor Bass skips a Streets for All forum. Also: No Kings.

March 25, 2026

Eyes on the Street: Progress on Folsom Streetscape Project

One of SoMa's major thoroughfares is getting long-overdue repairs that will include bike and ped safety improvements.

March 24, 2026

D.C. Advocates Sue To Save Key Bike Lane From Trump Teardown

We previously reported that the Trump administration might soon move to dismantle key cycle tracks in the nation's capital. Unfortunately, we were right.

March 24, 2026

Monrovia Seeks Input on Draft Bike Master Plan

The deadline for public comment is this Friday, March 27 2026.

March 24, 2026

Santa Rosa Quietly Approves Additional Mall Parking in Pedestrian and Art Plaza; Activists Appeal

“Why do they need more parking? It feels like they’re trying to sneak something by the public.’’

March 24, 2026
See all posts
